Ethiopia dam official blames construction delays on conglomerate METEC

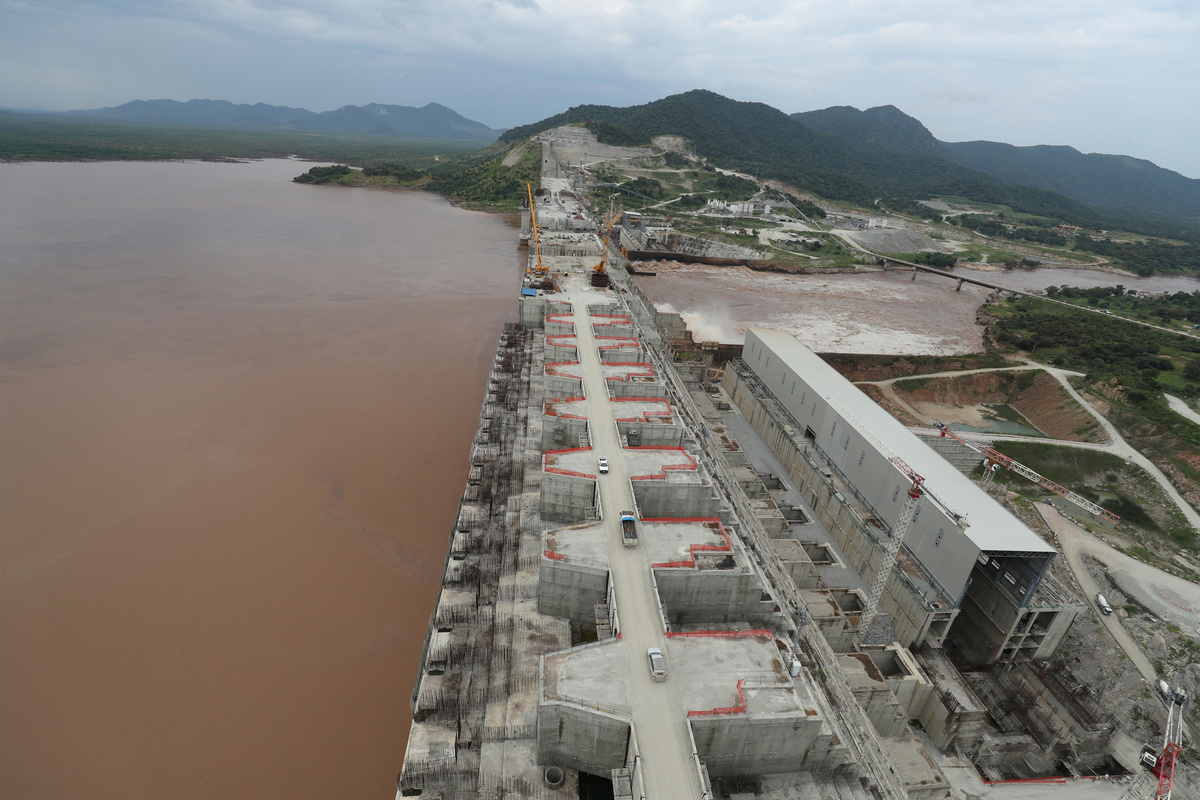

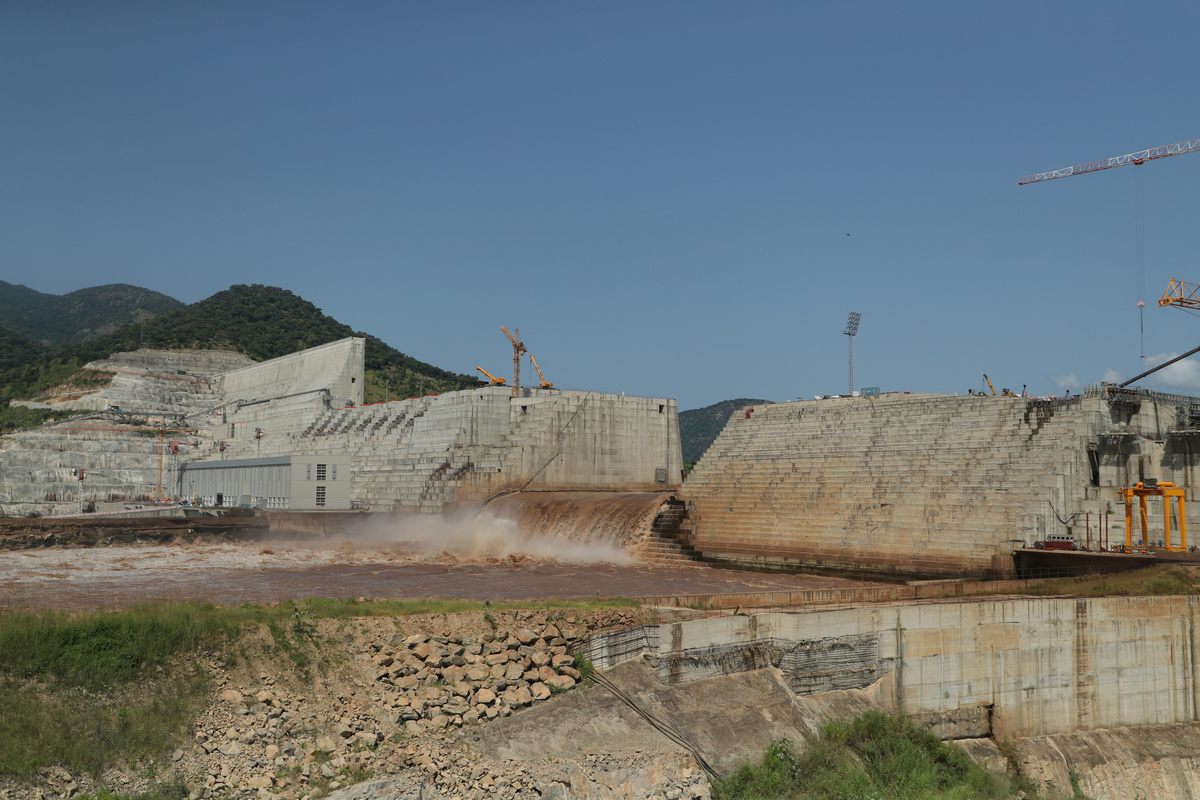

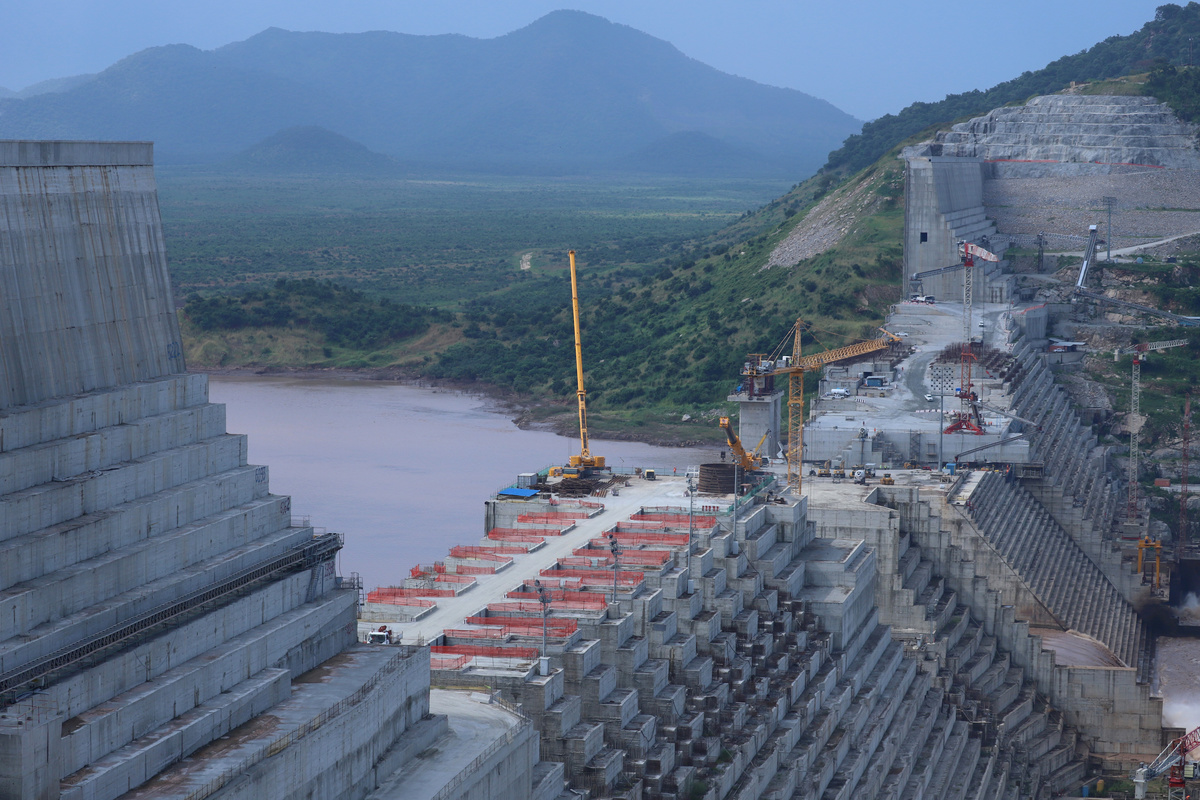

Ethiopia's Grand Renaissance Dam is seen as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

ASOSA, Ethiopia (Reuters) - Construction of a $4-billion dam at the heart of Ethiopia's bid to become Africa's biggest power exporter has been delayed five years as engineers had to replace shoddy work by a conglomerate pulled off the job last year, a project official said.

The Grand Ethiopian Renaissance Dam, announced in 2011, was designed to generate more than 6,000 megawatts in a region that struggles to produce enough energy, but has proved a lightning rod for tensions in both Ethiopia and Egypt.

"We have removed some of the steelworks on bottom outlets and replaced them with new ones," Belachew Kassa, the site coordinator and deputy head of the project, told Reuters during a trip to the dam last week. "We also readjusted and repaired some of the steel structure works."

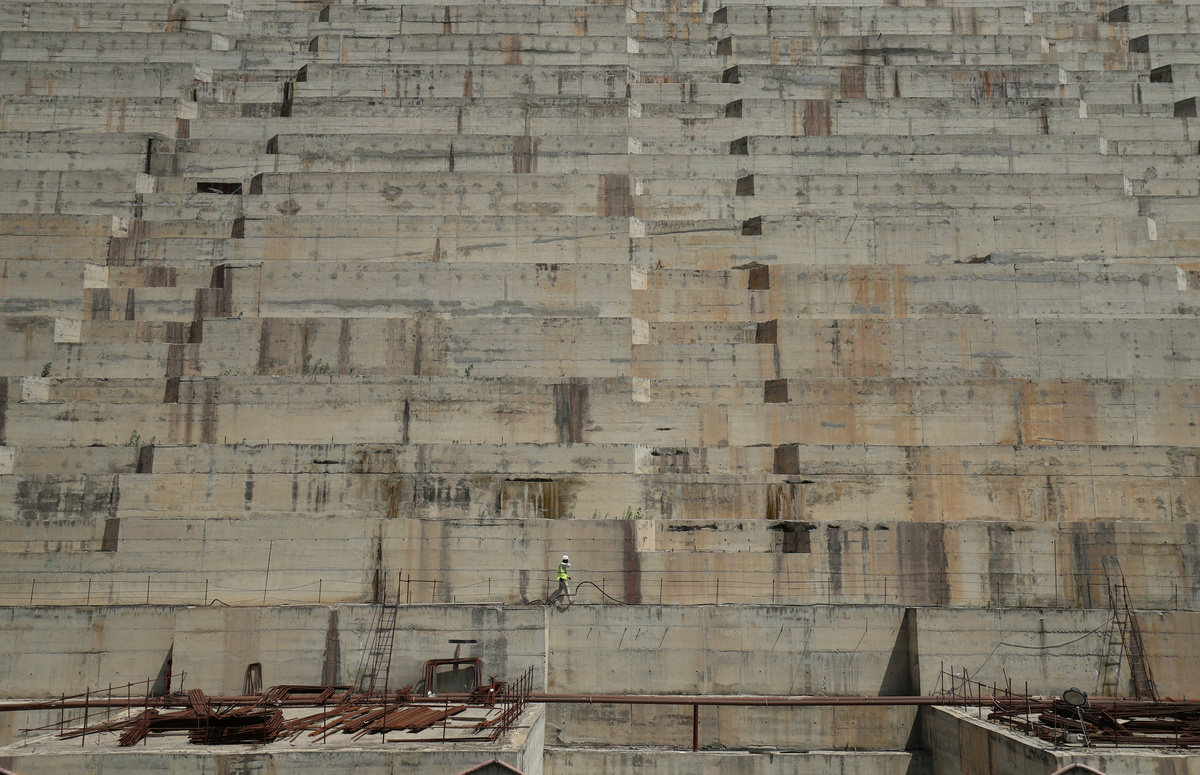

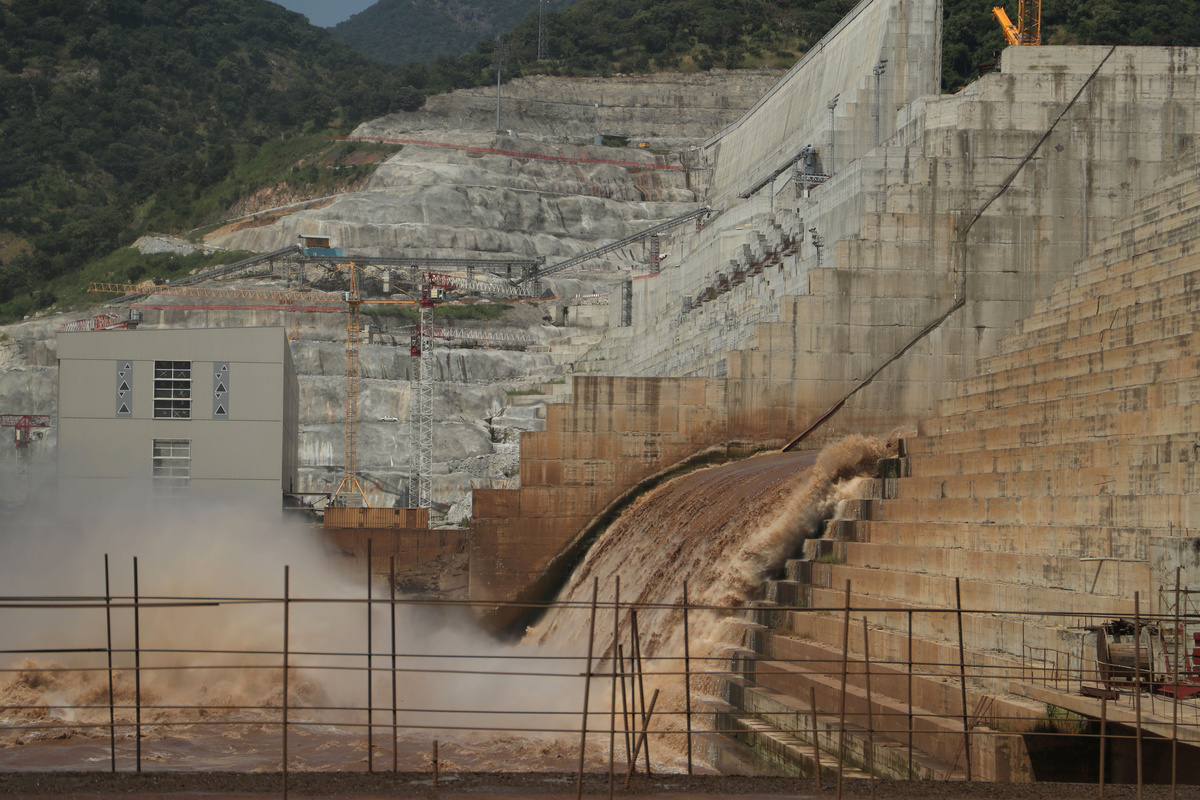

Water flows through Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

He added, "The bottom outlets ... were initially done by METEC," referring to Ethiopia's military-industrial conglomerate that undertook much of the building work but was pulled from the project in August last year after Prime Minister Abiy Ahmed took office that April.

"Our experts found that the bottom outlets were below quality (requirements)."

A bottom outlet is an opening at a low level from a reservoir that is generally used to freely discharge water.

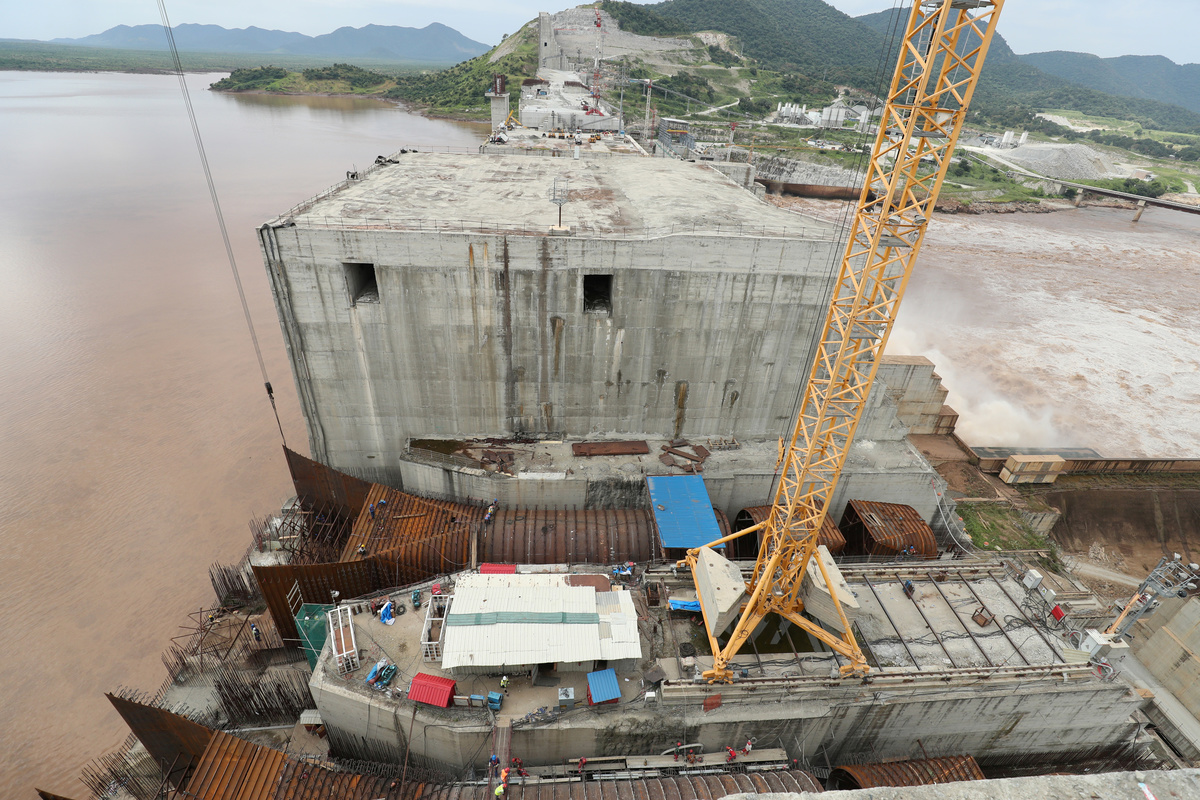

A man walks through a section of Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

Controversy in Ethiopia has focused on METEC's involvement in the project to dam the Nile, but Egypt sees the effort as an existential threat, since the river supplies nearly 90% of its fresh water for drinking, farming and industry.

Ethiopia has put the former head of METEC, Kinfe Dagnew, on trial after arresting him on corruption charges in November, along with dozens of employees.

Early this year, Ethiopia handed contracts to fulfil METEC's work to a group of foreign companies that include Italy's Salini Impregilo SpA, GE Hydro France, China Gezhouba Group Corp, Voith Hydro Shanghai and China's Sinohydro Corp[SINOH.UL].

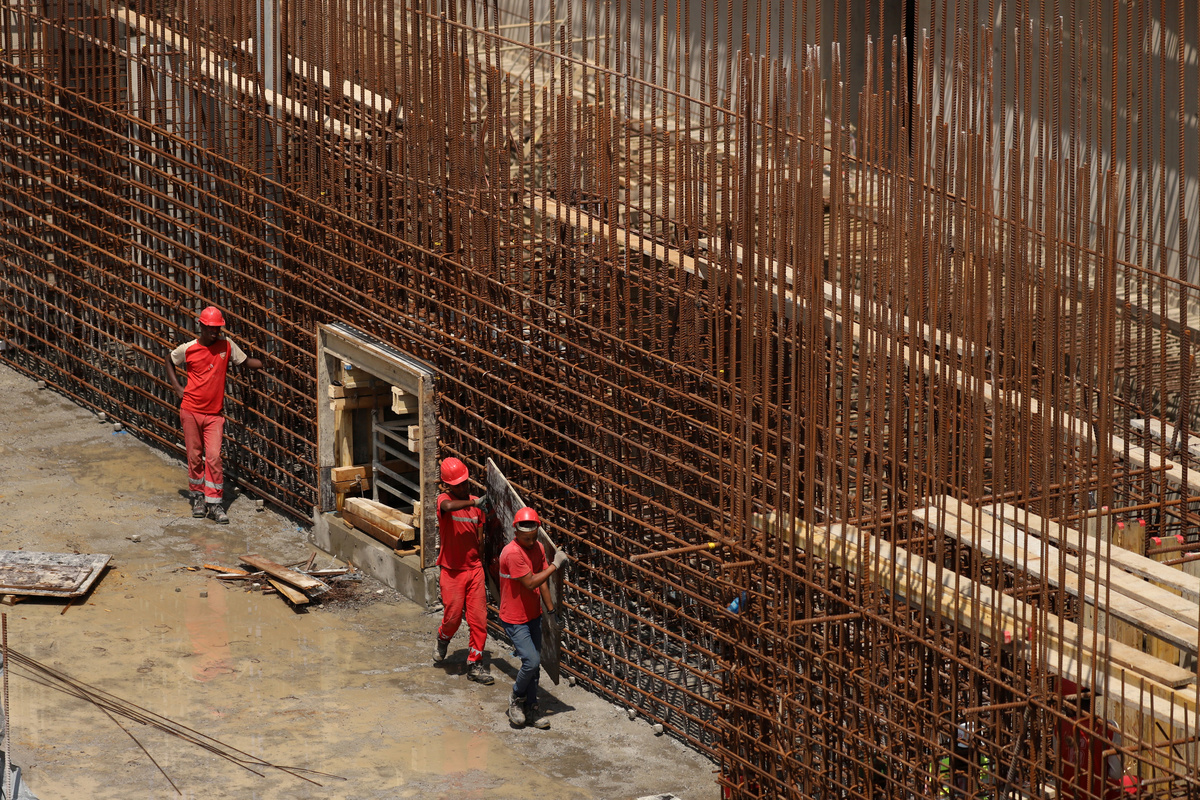

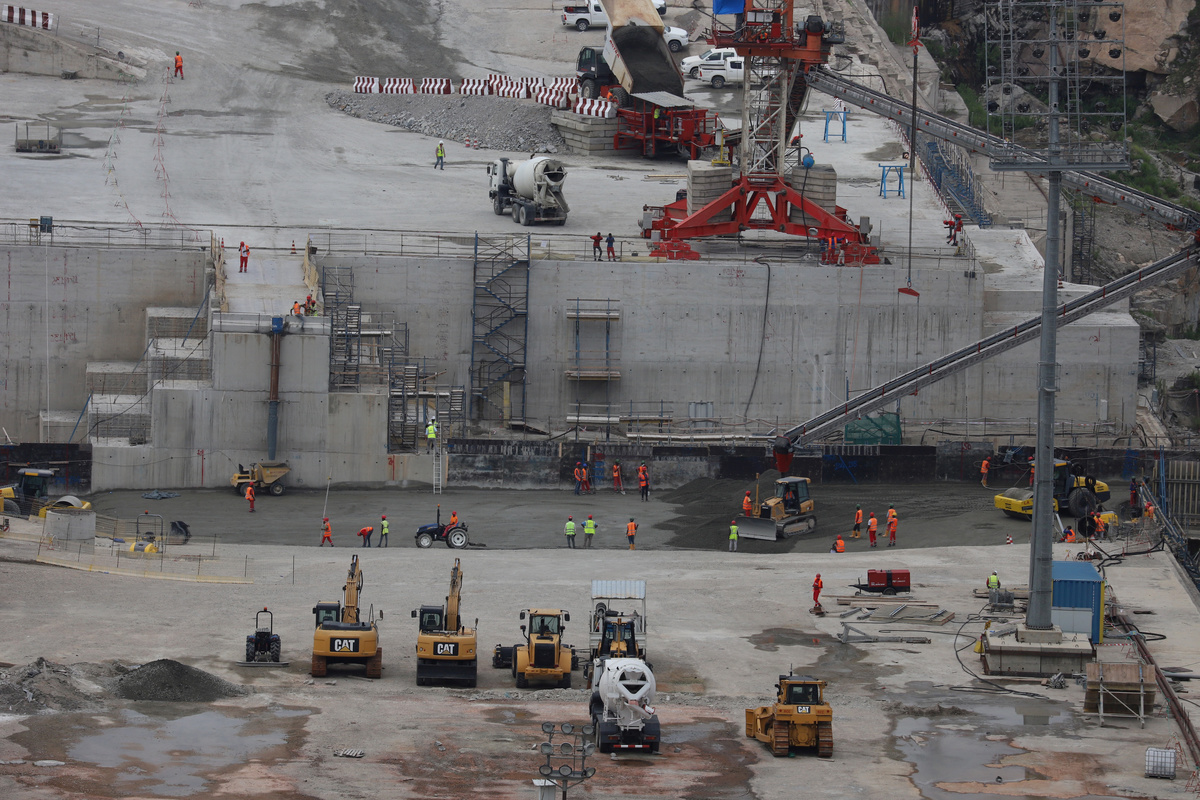

Workers and machinery are seen at Ethiopia's Grand Renaissance Dam as it undergoes construction on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

Belachew said it was unclear exactly how much METEC was to blame for delays that have put the project five years behind schedule. Although Abiy blamed METEC for problems last year, he did not say how long a delay they had caused.

The dam was initially supposed to have been finished in 2018, but an initial two turbines are now due to start generating 750 megawatts each in December 2020.

The entire dam is due to be completed by 2022, Ethiopia’s water minister, Seleshi Bekele, said last week.

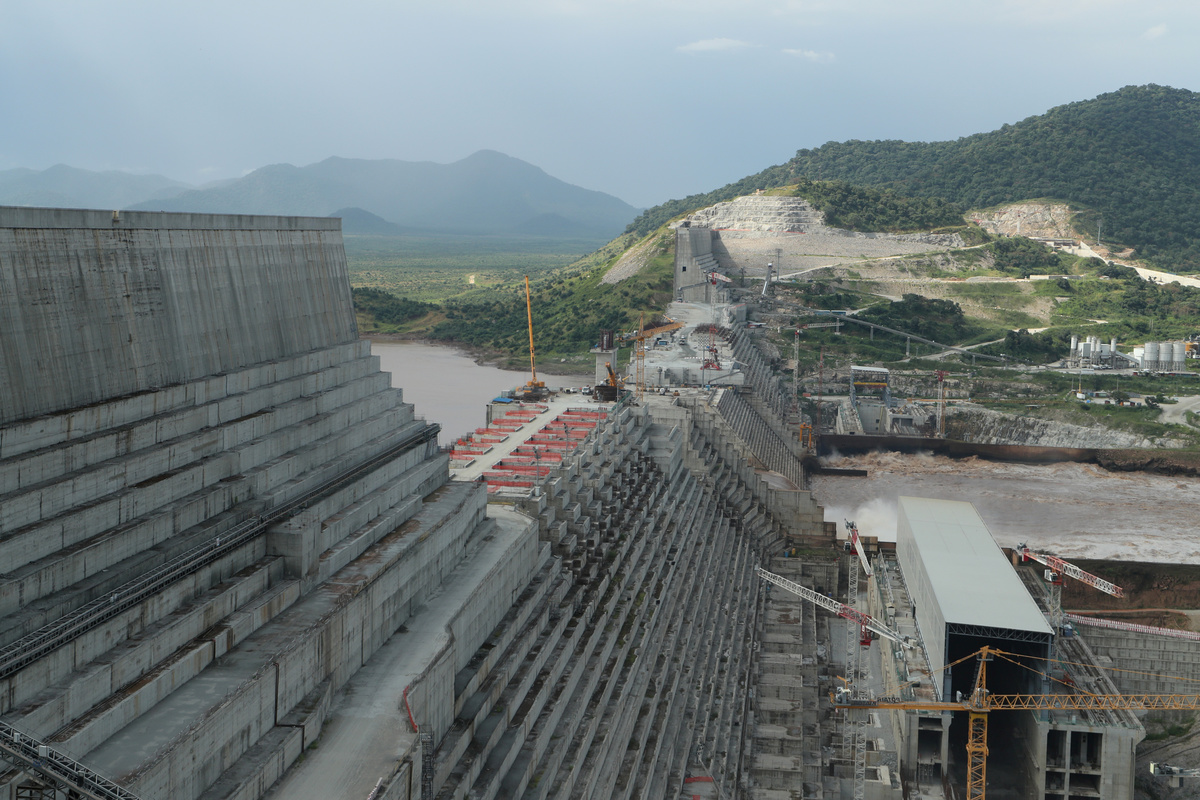

Construction workers are seen at Ethiopia's Grand Renaissance Dam on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

The hydropower dam on the Nile River is located 500 km (311 miles) northwest of the Ethiopian capital of Addis Ababa, near the border with Sudan.

(Writing by Katharine Houreld; Editing by Clarence Fernandez)

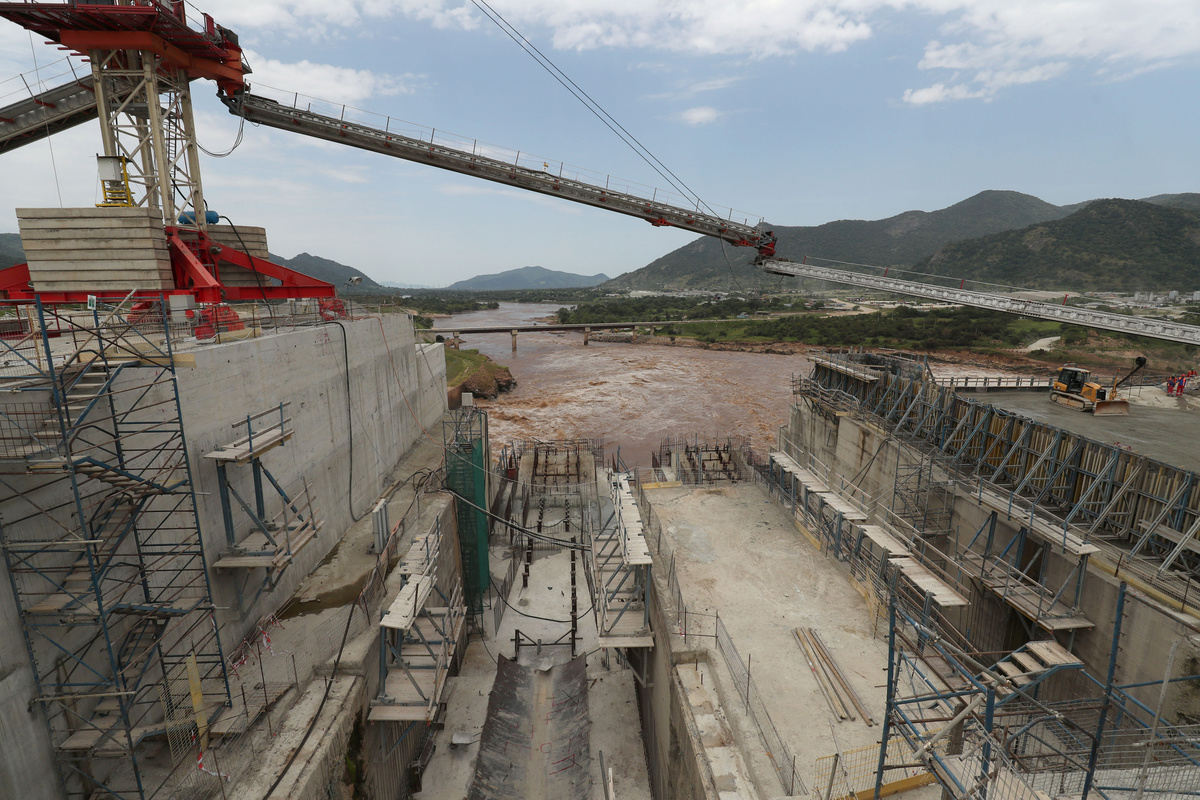

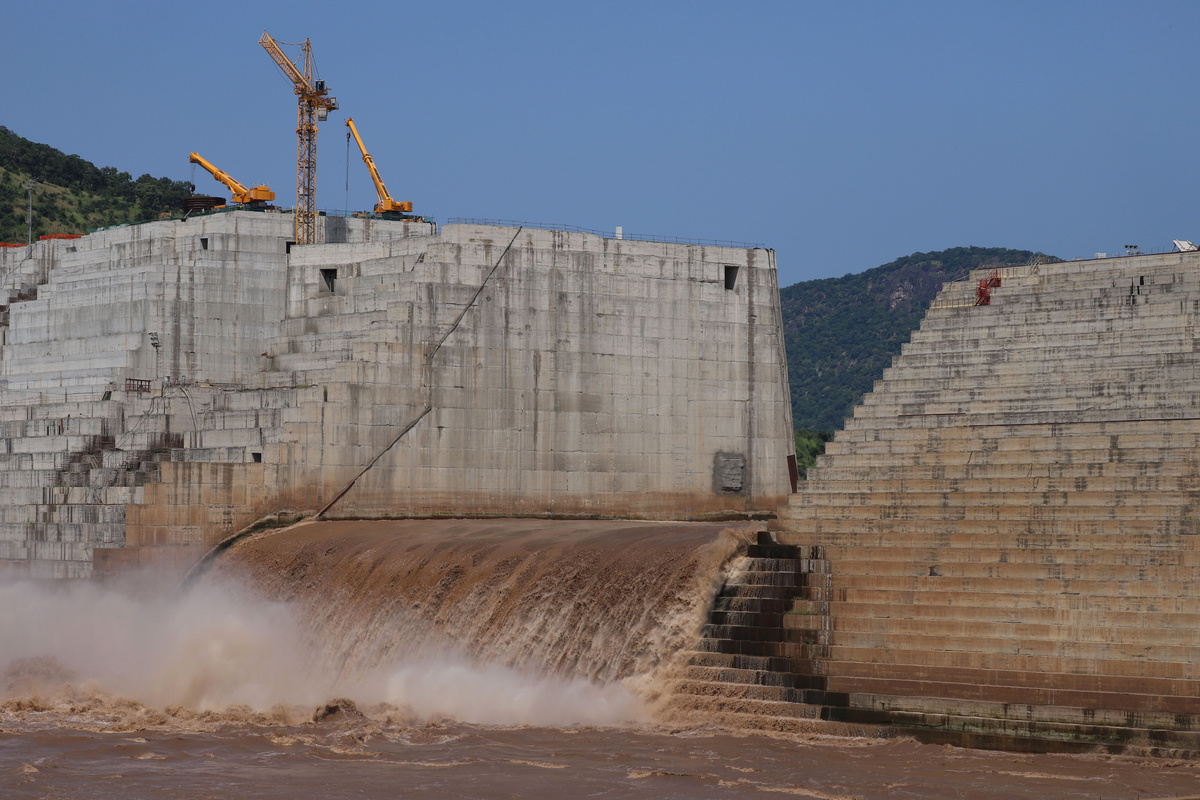

A saddle dam is seen Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Ethiopia's Grand Renaissance Dam is seen as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
A construction work is seen at Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

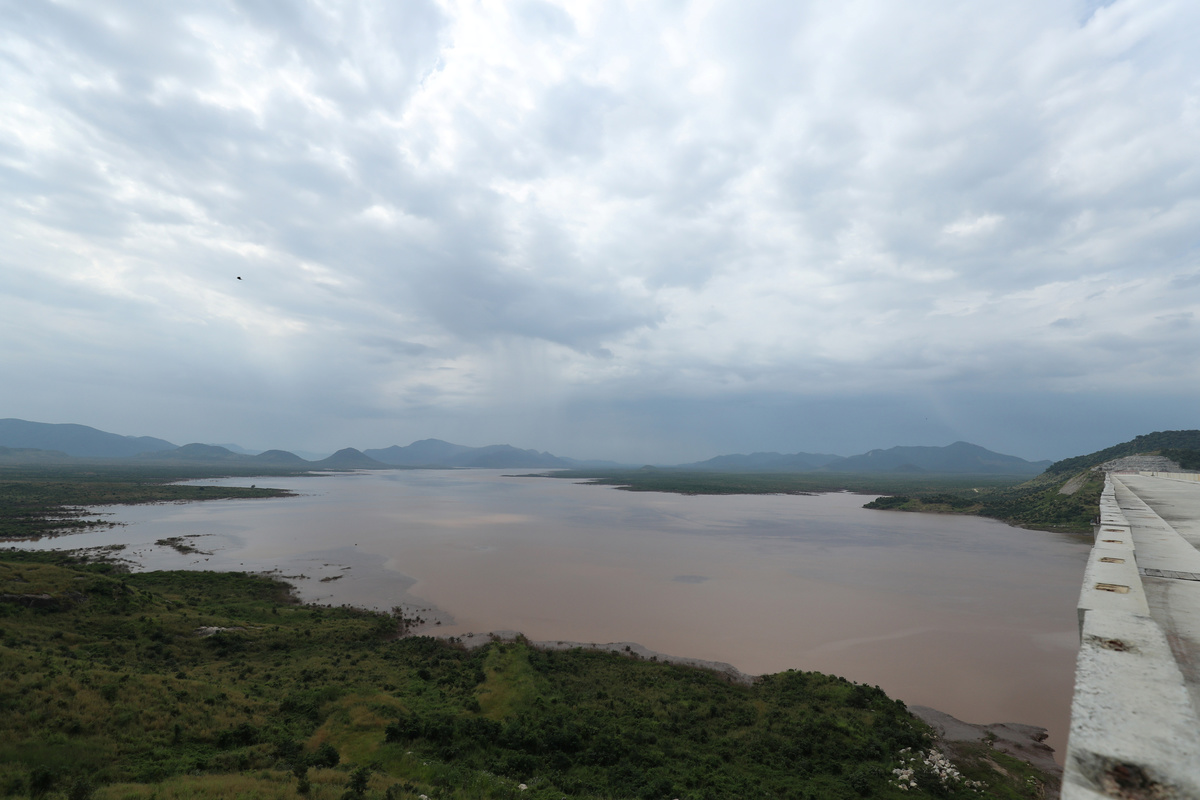

A water basin is seen near Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
A water basin is seen near Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Ethiopia's Grand Renaissance Dam is seen as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Ethiopia's Grand Renaissance Dam is seen as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

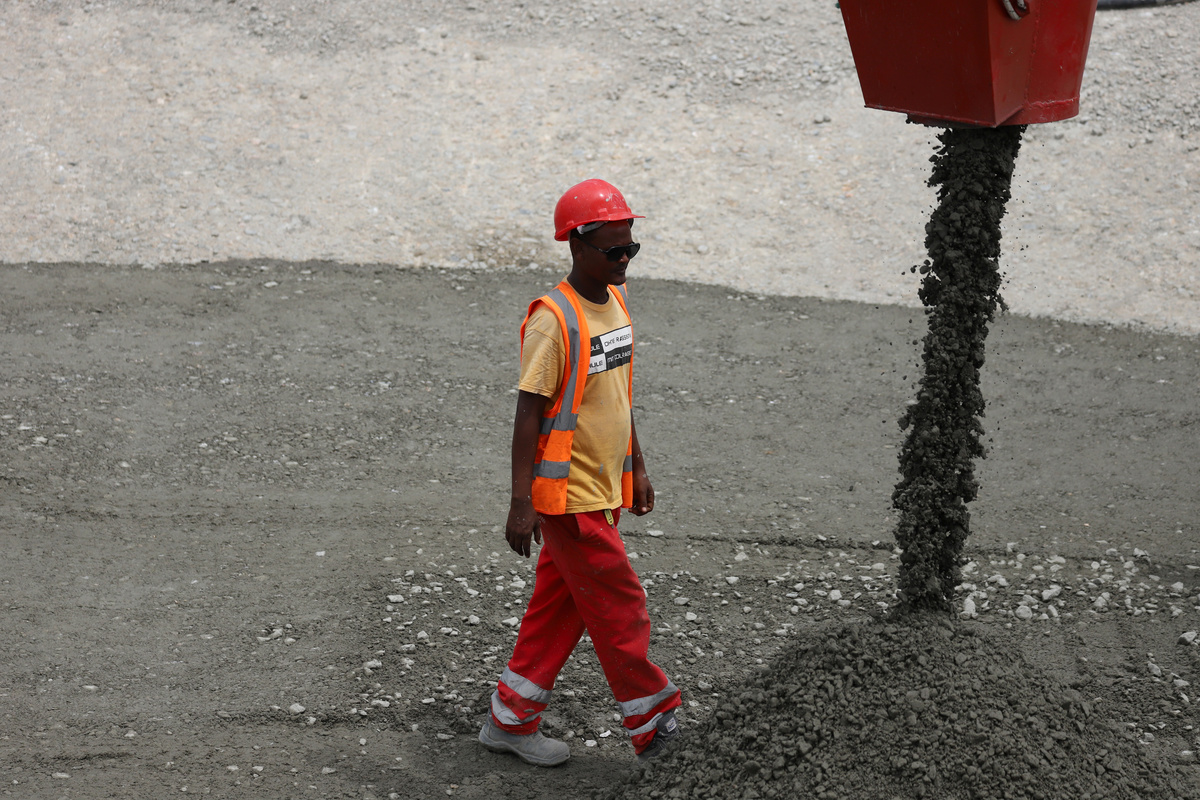

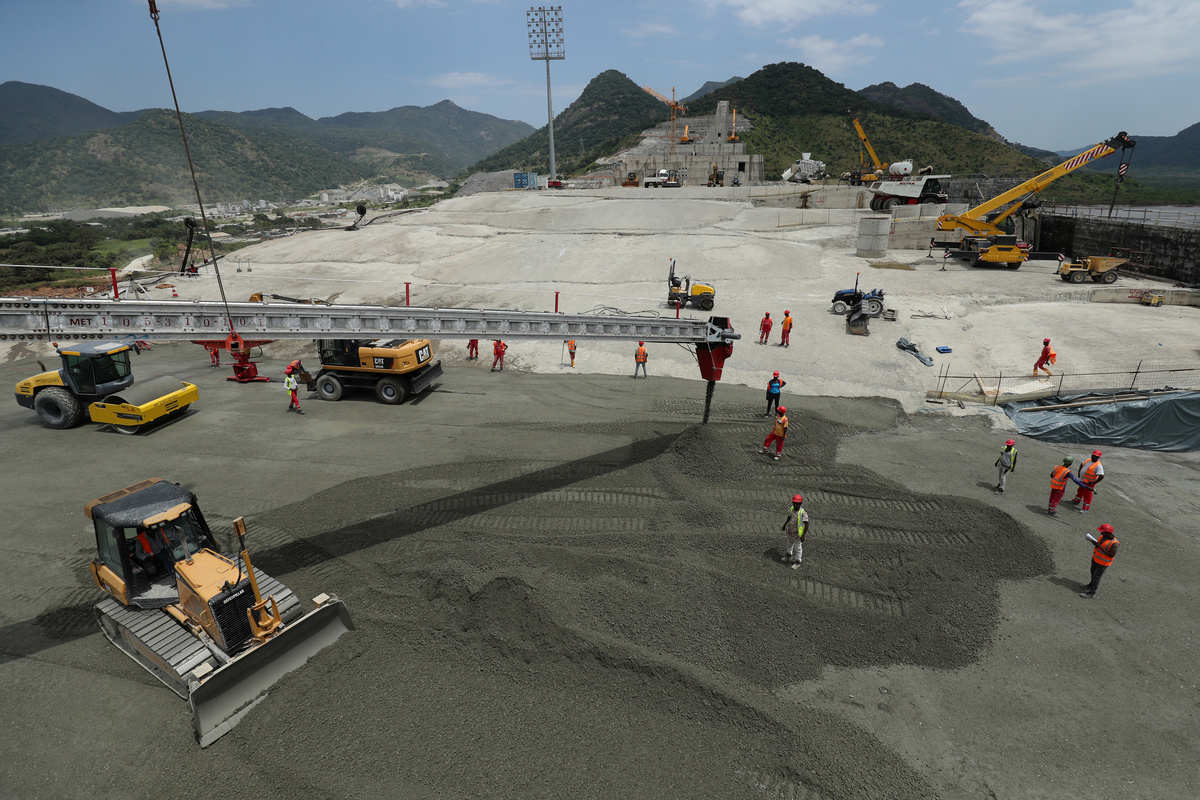

A construction worker is seen at the concrete filling section at Ethiopia's Grand Renaissance Dam as it undergoes construction on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Water flows through Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Welders work at Ethiopia's Grand Renaissance Dam as it undergoes construction on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

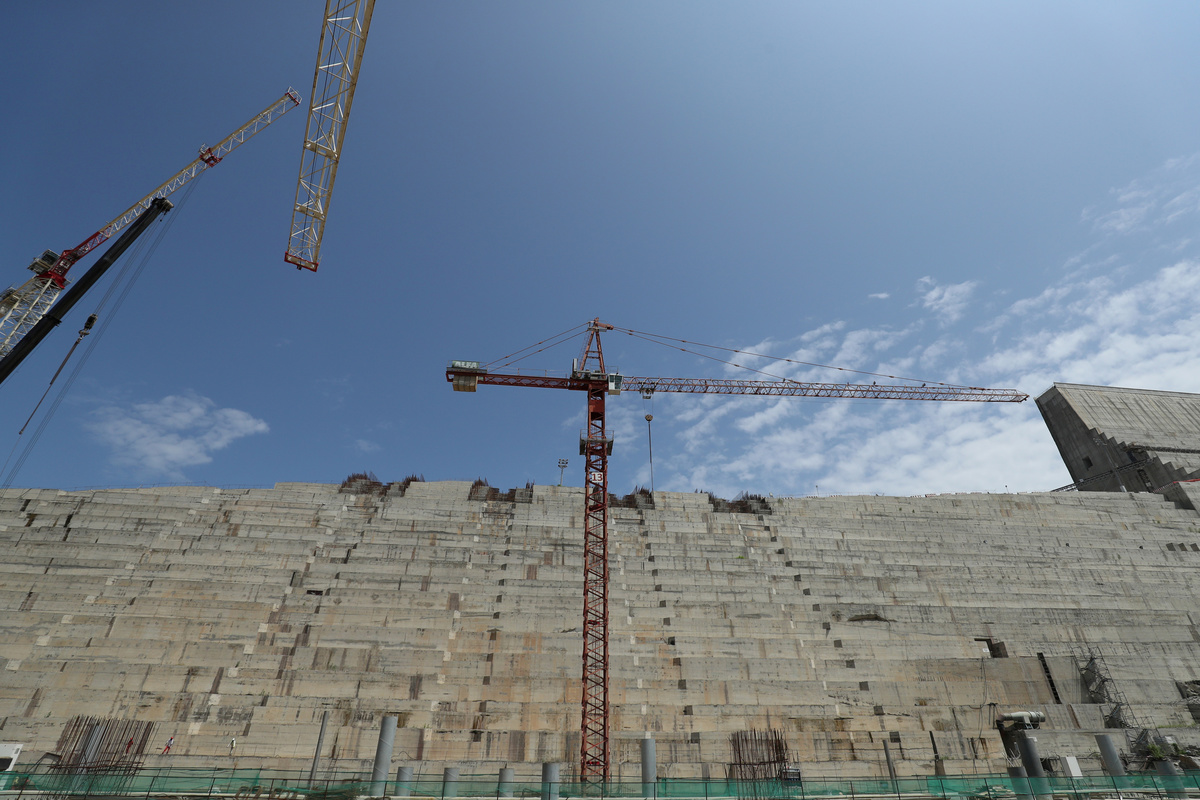

Ethiopia's Grand Renaissance Dam powerhouse is seen as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

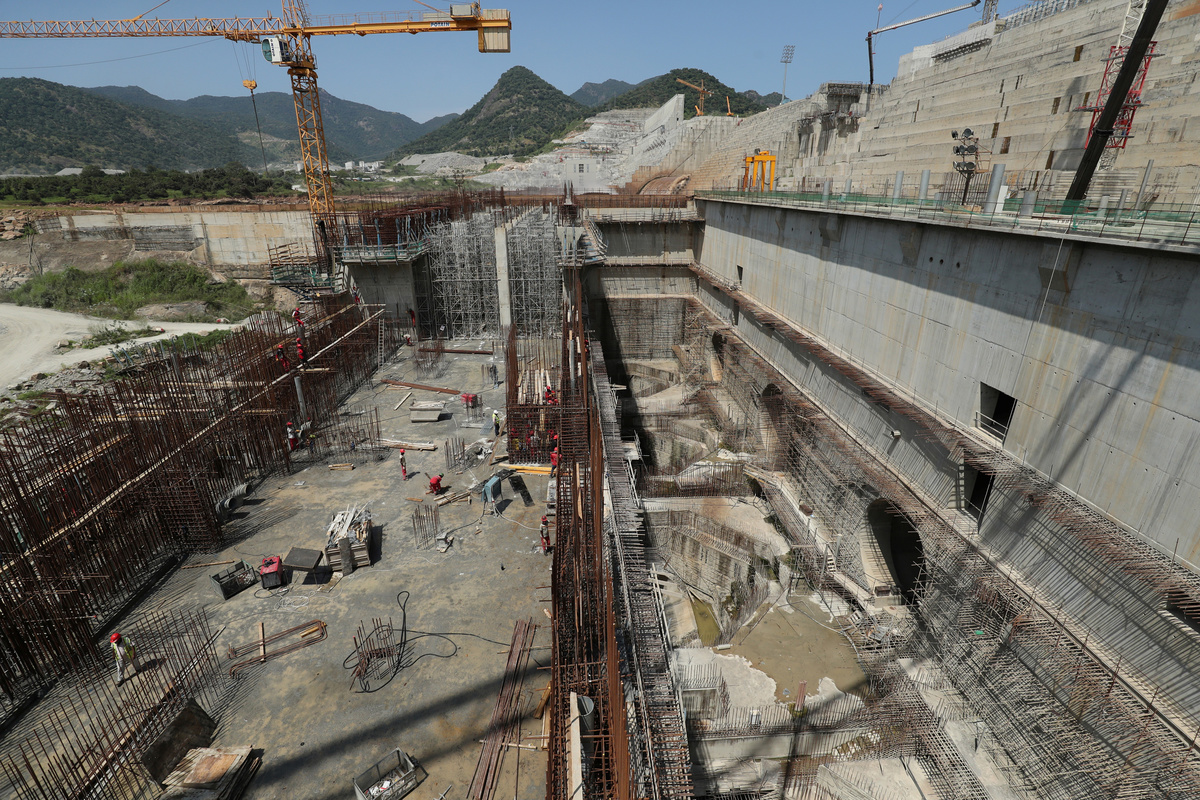

A construction worker walks near the stop log section at Ethiopia's Grand Renaissance Dam as it undergoes construction on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Ethiopia's Grand Renaissance Dam seen as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Ethiopia's Grand Renaissance Dam is seen as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
A view of Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Workers and machinery are seen at Ethiopia's Grand Renaissance Dam as it undergoes construction on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri

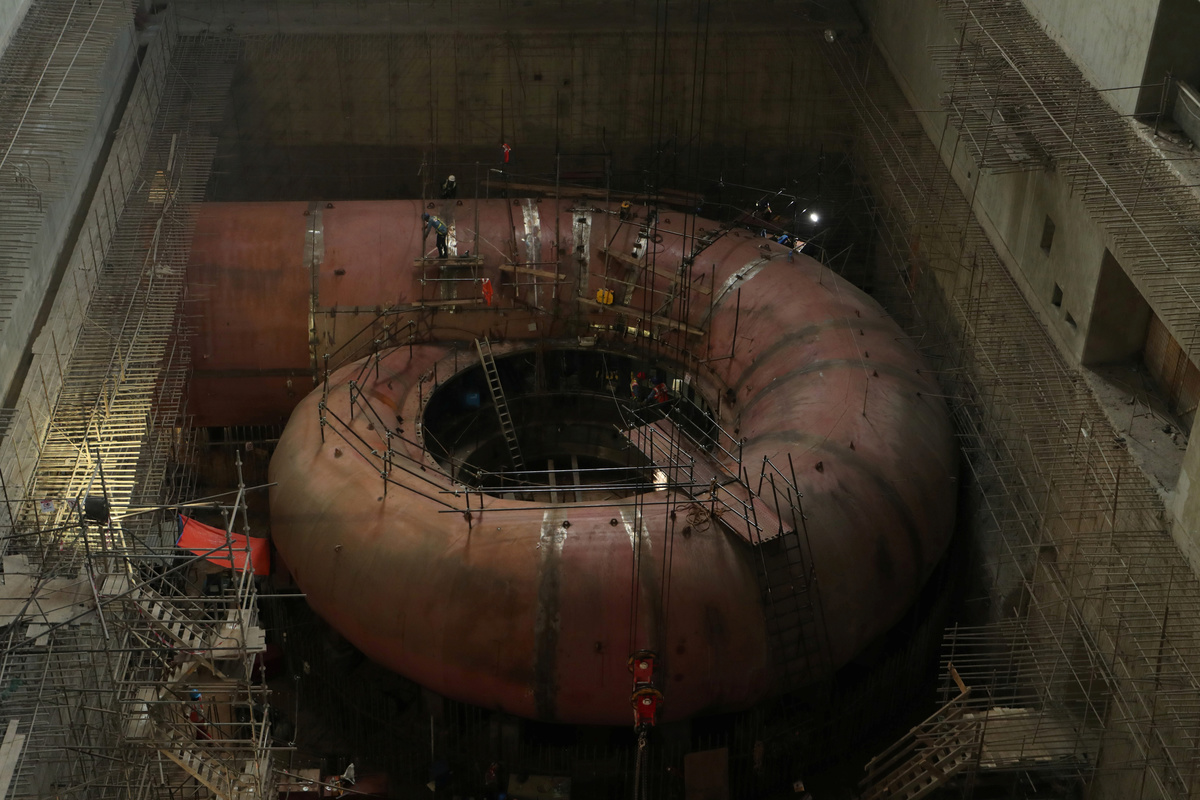

A turbine housing at Ethiopia's Grand Renaissance Dam powerhouse is seen as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
FILE PHOTO: A view of Ethiopia's Grand Renaissance Dam as it undergoes construction work on the river Nile in Guba Woreda, Benishangul Gumuz Region, Ethiopia September 26, 2019. REUTERS/Tiksa Negeri
Sign up to read this article
Read news from 100’s of titles, curated specifically for you.
Already a member? Sign in here
Related Stories
Top stories on inkl right now
One subscription that gives you access to news from hundreds of sites
Already a member? Sign in here
Our Picks
Fourteen days free
Download the app
One app. One membership.
100+ trusted global sources.
